The construction of solar energy system projects, commonly referred to as Solar Farms, often requires the owners/operators of the project to submit applications to local, state, and federal agencies before construction begins. From SCDES, these often include:
| Program | Activities Covered | Timing of Submission |
|---|---|---|
| NPDES Construction Stormwater | This permit is required when the project will disturb one acre or more of land anywhere in the state. | Before Construction Begins |
| 401 Water Quality Certification | This certification is necessary when the project includes impacts to Waters of the United States that require a 404 permit from the U.S. Army Corps of Engineers. | Before Construction Begins |
| Coastal Zone Consistency Certification | Certification that permits issued in South Carolina’s 8 coastal counties are consistent with the state’s Coastal Zone Management Plan, including impacts to wetlands, threatened/endangered species and archeological & historic resources. | Before Construction Begins |
| Registration for Solar Energy System Decommissioning | Operators of solar energy systems of greater than 13 acres are required to submit to the Department a decommissioning plan for review and approval that addresses end-of-life management of solar panels and batteries. | Five Years Prior to Solar Energy System Retirement |

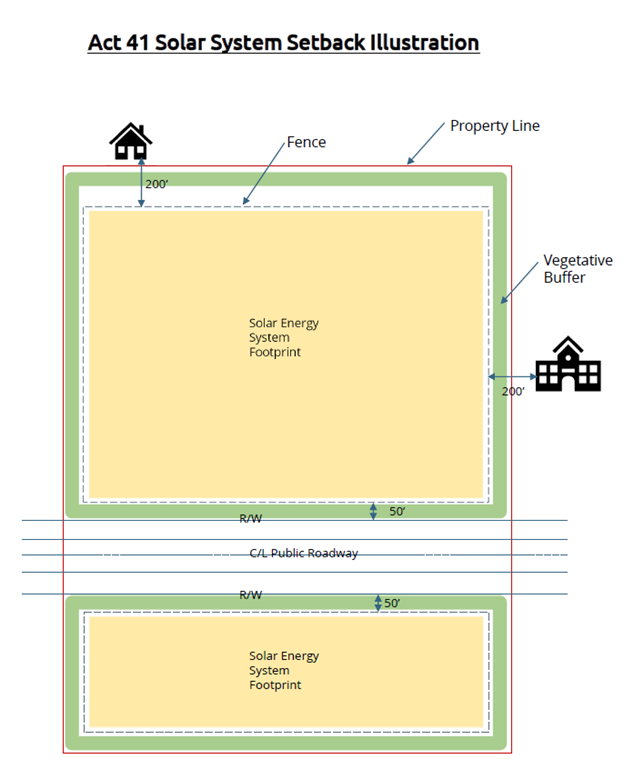

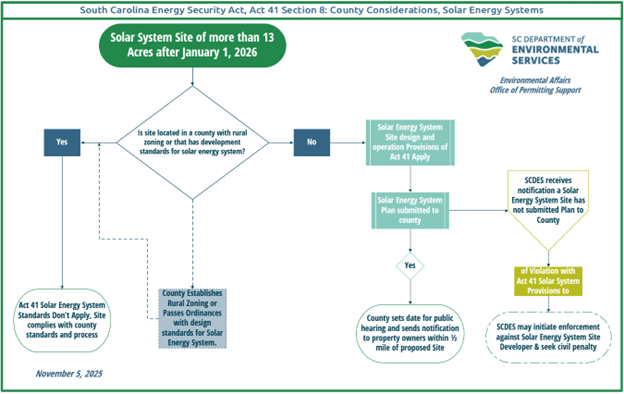

Beyond these, the South Carolina’s Energy Security Act (Act 41) established standards for the design and development of Solar Energy Systems with a footprint of more than thirteen acres of land. These rules apply in only those counties without rural zoning or an ordinance for solar energy systems. If a county has one or the other, the provisions of Act 41’s county considerations for solar energy systems don’t apply.
